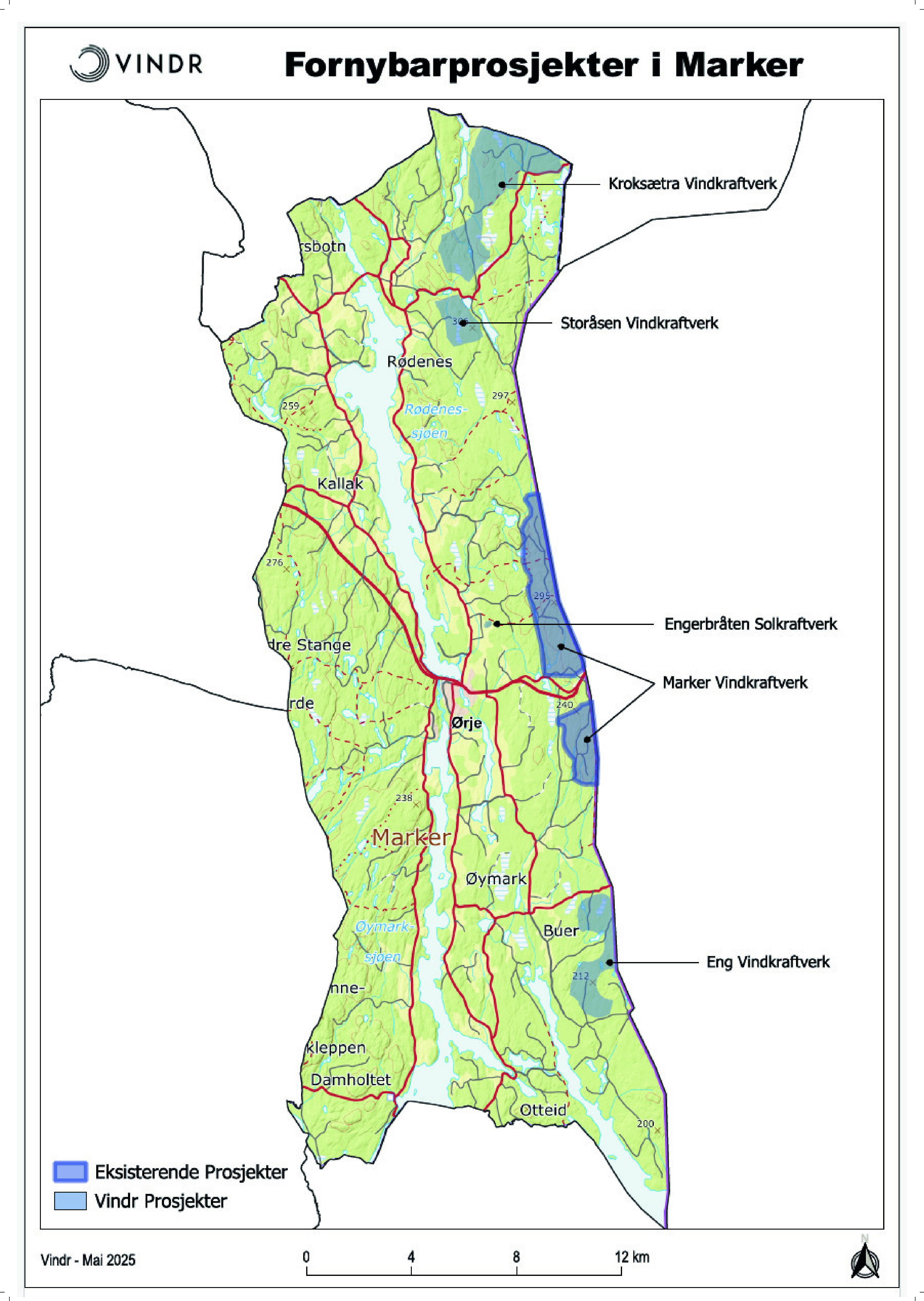

Renewable Projects in Marker

The projects in Marker can contribute approximately 790 GWh of green energy, meet the region’s power demand and facilitate industrial jobs.

Location
Marker Municipality
Status
Early phase: planning
Turbines
20-35
Solar panels
Ca 4600
Production
Ca 790 GWh
Effect
Up to 220 MW
Turbine height
Up to 270 m total height

Local contribution

The proposed wind projects in Marker municipality will provide the municipality with increased revenue via property tax and production fees, as well as a share of the resource rent tax.

Assuming production of 790 GWh and a property tax rate of 0.7 %, it is estimated to generate an annual contribution of between NOK 20 and 30 million.

The solar plant at Engerbråten will consist of 4,608 solar panels and produce 3 GWh per year – enough to supply around 200 households.

Establishing new or upgrading existing grids, combined with new power production from wind- and solar-plants, offers opportunities for new industrial establishment in the region. The projects will also generate local economic ripple-effects during construction and in ongoing operations, through purchase of goods and services regionally and local employment.

Project timeline

2025

Project idea and landowner agreements

The project is being established in consultation with the landowner.

Current phase

2026

Planning and investigation programmes

Local meetings

2026 - 2027

Area plan and environmental impact assessment prepared based on applicable guidelines

Prepared in accordance with current guidelines

2028

Konsesjonssøknad

2028

Political processing of area plans

Licence application

2029

Political processing of area plans

Licence processing by authorities; Possible complaint processing 2029-2031

2029

Complaint handling, if applicable

2029-2031

Contracting and project planning 

2031 – 2032

Construction

2032

Operation
